How to estimate how long a project will take

Break it down, check it against your own history, add a buffer on purpose, and re-estimate as you go. With a worked example.

Updated 2026-10-27

Every fixed price and every "about how long will this take?" rests on a time estimate. Get it right and the project pays what you planned. Get it wrong and you find out at high noon, on deadline day, with the hardest part still ahead and the budget already spent.

Estimating is a skill, not a talent, and it gets better with a simple routine: break the work down, check it against your own history, add a buffer on purpose, and re-estimate as you go. Here is each step, with an example you can copy.

Step 1: break the project into pieces you can picture

"Build a website" is impossible to estimate. "Design the homepage" is easier. "Design the homepage header and hero, desktop and phone" is something you can actually picture doing, and that is the level you want.

A good rule: keep breaking a task down until each piece is something you could finish in a day or less. Then estimate each piece on its own and add them up. Small pieces are easier to guess, and the errors tend to cancel out instead of piling up in one big number.

Don't forget the work around the work. These pieces are real hours and are easy to leave off:

  • Kickoff call, questions and reading the client's material.
  • Setting up files, accounts and access.
  • Rounds of feedback and changes (count them, see step 3).
  • Meetings and status updates during the project.
  • Preparing the final files and handing them over.

Step 2: use your own tracked history, not a guess

The most reliable estimate comes from how long the same kind of work took you last time. Not how long it should take, and not how long it takes someone else: how long it actually took you, including the interruptions.

That only works if you tracked it. When you track time per client and per project, every finished job becomes a reference for the next one. A weekly timesheet makes the pattern easy to see.

tab's weekly timesheet with rows by client and project and columns for each day: Bramble, Logo, 1.58 hours total; Harbor & Pine, 1.25; Loop Studio, Monthly retainer, 2.75; Northwind, App redesign, 7.25
A week of tracked time by client and project. Sample data.

If you are just starting and have no history yet, track the first few projects carefully, even ones you bill at a flat fee. You can also write down your estimate before each task and compare it with the time you track. After a handful of jobs you will see your own pattern, such as underestimating revisions or overestimating writing.

No account needed to start building that history: the meter on the homepage times work against a client and rate right in your browser.

Step 3: add a buffer, and say what it covers

Every project has things you can't foresee: slow feedback, a missing file, a change of mind. A buffer is how you pay for them without working for free. Add it after you total the pieces, as a separate line, rather than padding each task quietly.

How big? Your history is the honest answer: if your tracked projects usually run over your first estimate by a certain share, that share is your buffer. Unfamiliar work, a new client or vague requirements all deserve a bigger one. Revisions deserve their own line: estimate one round, multiply by the number of rounds your contract includes, and bill extra rounds separately. The contract basics note covers how to write that down.

A worked example, with illustrative numbers:

Example estimateHomepage redesign: estimateDiscovery and kickoff: 2 h. Homepage design, desktop and phone: 8 h. Two inner pages: 6 h. Two rounds of changes: 4 h. Handoff files: 2 h. Subtotal: 22 h. Buffer for the unexpected: 4 h. Estimate: 26 h, at $110/h = $2,860.

Step 4: turn hours into a price

For hourly work, share the estimate as a range of hours and keep the client updated as you go. For a fixed price, multiply the estimate, buffer included, by your hourly rate. If that rate isn't settled yet, what goes into a freelance rate walks through it and the hourly rate calculator does the math. If the client pushes on the total, trade scope rather than hours; how to negotiate your rate has wording for that.

Step 5: re-estimate while the project runs

An estimate is a plan, not a promise you have to keep silently. Check it at set points: after the first quarter of the work, and whenever the scope changes. If you are already past half the hours with less than half done, say so early: "This is taking longer than planned because of X. To stay on budget, we could drop Y, or I can quote the extra."

In tab, you can give any project an estimate in hours. The client page shows the hours used against it, and the Money screen lists your projects under "Estimates vs actual," so you see a project running long while there is still time to talk about it.

For fixed-price work, tab also shows what the project is really paying per hour so far, from every hour you tracked, next to your normal rate.

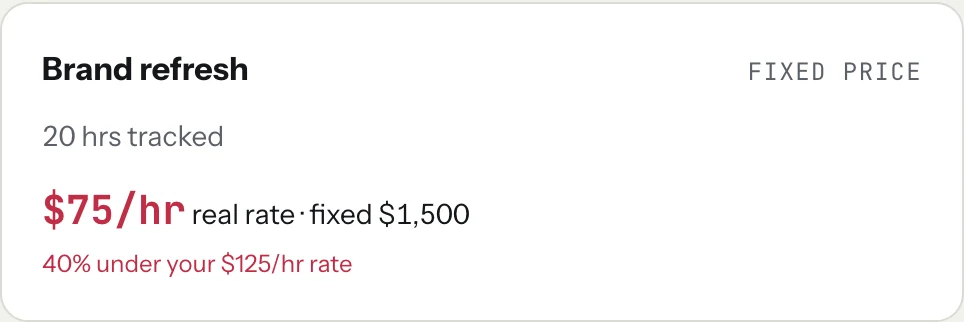

A fixed-price project card in tab: Brand refresh, Fixed price, 20 hrs tracked, $75/hr real rate in red, fixed $1,500, 40% under your $125/hr rate
A $1,500 project that has taken 20 hours: the estimate was off, and the card says so. Sample data.

Step 6: close the loop when it's done

When a project ends, take five minutes to compare the estimate with what you tracked, piece by piece. Which parts ran long? Which were faster? Write it down next to the estimate. That comparison is what makes the next estimate better, and over time it turns your history into your best pricing tool. You can export every time entry as a CSV file if you like to keep the numbers in a spreadsheet.

And when the hours are in, turn them into a bill: the timesheet to invoice tool makes line items from your hours.

Start the clock, no accountSign up free

Checked October 26, 2026. Hours and prices in the examples are illustrations, not market data.

Know a freelancer who needs this?

Get new notes

New notes in your inbox, about once a week.

Practical guides to getting paid for your time. Make a free tab account and they come with it, or just leave your email. One click to leave.

Questions

How do I estimate how long a freelance project will take?

Break the project into pieces of a day or less, estimate each piece, and add them up, including calls, feedback rounds and handoff. Compare with how long similar work took you before, add a buffer as a separate line, and re-check the estimate as the project runs.

How much buffer should I add to a project estimate?

Use your own history: if your tracked projects usually run over your first estimate by a certain share, use that share. New clients, unfamiliar work and vague requirements deserve a bigger buffer. Show it as its own line instead of padding every task.

What if a project is taking longer than I estimated?

Tell the client early, explain why, and offer choices: drop part of the scope to stay on budget, or approve extra hours or a change in price. Raising it halfway through is far easier than at the deadline.

Should I track time on fixed-price projects?

Yes. Tracking shows what the project really paid per hour and builds the history that makes your next estimate more accurate. In tab, a fixed-price project shows its real hourly rate next to your normal rate as you track.
